An 8-engineer team built and raced a full-scale locomotive at the Institution of Mechanical Engineers' Railway Challenge. My role: validate and manufacture the bogie and unsprung assembly, and bring the entire locomotive into compliance with IMechE's mandatory dynamic loading gauge.
Can a team-designed locomotive bogie be independently validated component-by-component, manufactured to schedule, and brought into compliance with the Institution of Mechanical Engineers' mandatory physical envelope — all before a fixed competition deadline?
The IMechE Railway Challenge is a genuine systems-engineering competition: 8 team members across mechanical, electrical, and controls disciplines had to design, manufacture, and race a real locomotive against international university teams at Stapleford Miniature Railway — sponsored by industry partners who expected a working machine, not just a design study. Every structural component has to survive real dynamic loads, and the whole vehicle must physically fit within a strict regulatory envelope before it's even allowed to compete. There's no partial credit for a locomotive that doesn't fit the track or fails on the day.

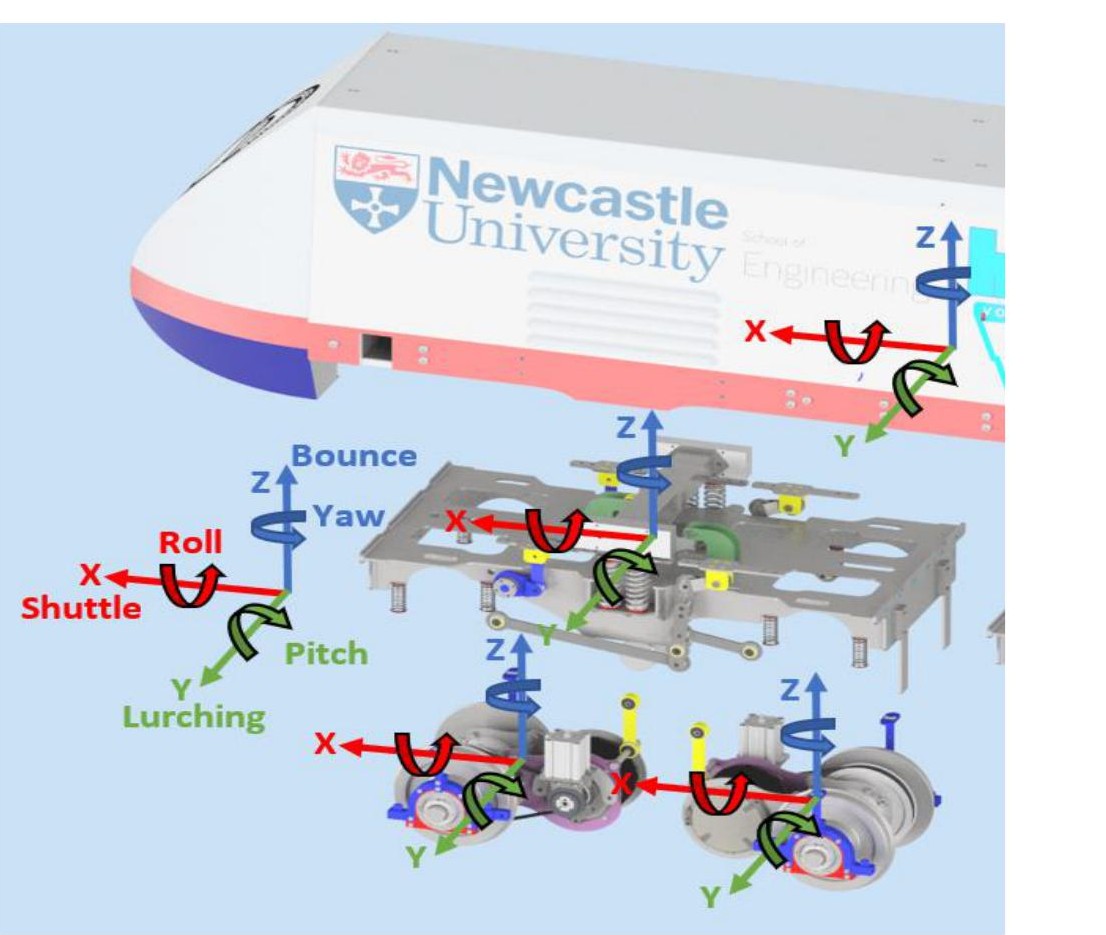

This mattered because none of those six motions are independent: constrain roll too tightly with the anti-roll bar and there's no travel left to absorb track twist; leave yaw too free at the bogie-body interface and the locomotive's body swings excessively into corners. Working from first principles, I calculated the deflection each interface needed under both regimes — for example, roll between wheelset and bogie needed 11.5° unconstrained down to 0.439° once the axle box T-bar was sized correctly — and used that pairing of numbers, not just the axle box T-bar name, to size and specify every bushing, spring, and hook in the bogie.

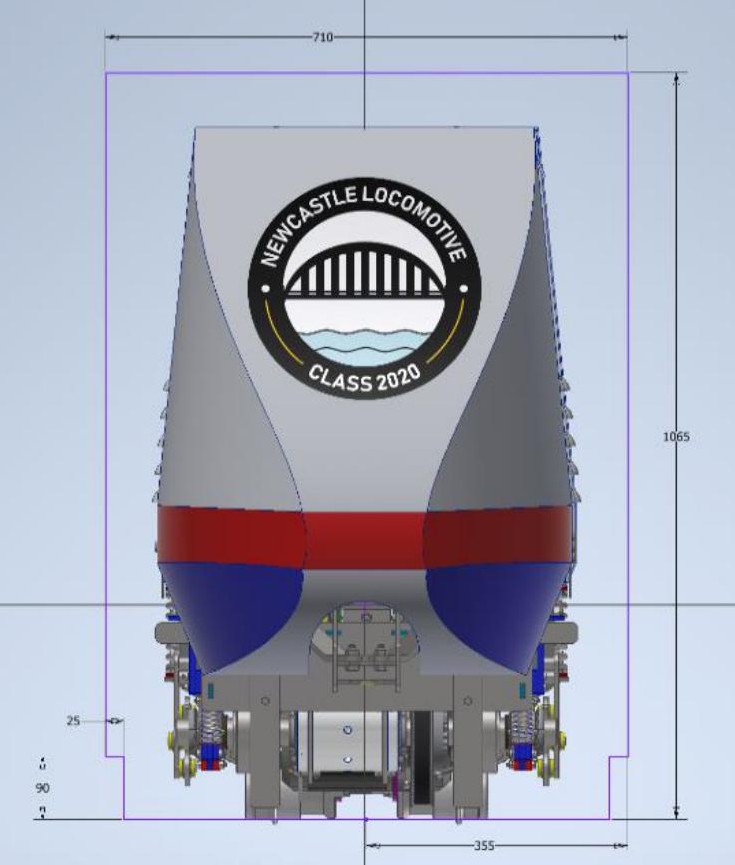

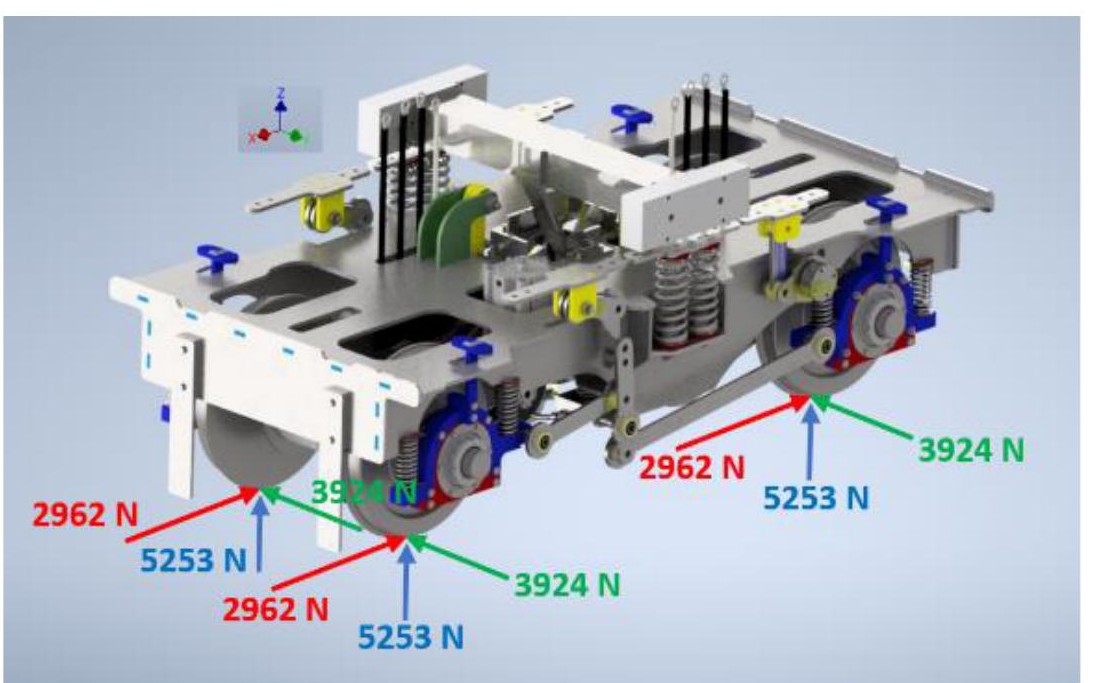

Every friction coupling in the locomotive was validated with a safety factor above 2.8 (up to 16.5 on the wheel-axle coupling), and after redesigning the anti-roll bar and tightening suspension travel limits, the locomotive fit within its mandatory dynamic envelope with 26.9mm of clearance at the roof and 6.5mm at its widest point — comfortably compliant, but with margins tight enough that every earlier calculation genuinely mattered.
This was hands-on systems engineering under a fixed, external deadline: validating real components against calculated loads, then personally manufacturing the assemblies those calculations were for — with no opportunity to redo a physical part once it existed. That same discipline — calculate, validate, build, and verify the finished hardware actually complies with the requirement — carried directly into designing, manufacturing, and commissioning the custom wind tunnel used throughout the DPhil's experimental work.
